ONE PROJECT.A CONNECTED
DELIVERY SYSTEM.

Yas Riva North Marina Villas. 151 villas. 500+ BIM models. 1,960+ drawing deliverables. BIM delivery built through standards, coordination and weekly follow-up.

LOCATION
Yas Island, Abu Dhabi · UAE
MY ROLE
BIM Manager
CAREER STAGE
Al Firas General Contracting L.L.C
2025–2026
PROJECT CONTEXT
Residential · Construction BIM
Yas Riva overview rendering View detail

INTRODUCTION

The project was not only about handling 151 villas. It meant managing a contractor BIM scope of 500+ BIM models and 1,960+ drawing deliverables while keeping information, coordination and weekly delivery connected.

01 / YAS RIVA

Context

Yas Riva North Marina Villas is a 151-villa development on Yas Island, Abu Dhabi. Aldar is the client, AtkinsRéalis the consultant and Al Firas General Contracting the contractor. My role was to manage the BIM delivery flow behind a contractor scope of 500+ BIM models and 1,960+ drawing deliverables, and keep that system working week after week.

Villas
151
BIM models managed
500+
Drawing deliverables
1,960+
Delivery rhythm
Weekly

02 / YAS RIVA

My contribution

I worked on the project as a connected sequence, from receiving the information to tracking weekly delivery.

01 · IFC intake and review

Reviewed the received drawings and models, compared package content and checked the starting point before production began.

02 · EIR understanding

Used the EIR to define what the project had to deliver, how the information should be structured and what the BIM workflow should support.

03 · Mobilization and BIM Kick-Off

Prepared the kick-off presentation and aligned the team around scope, responsibilities, QA/QC, coordination and delivery expectations.

04 · BEP development

Built the execution roadmap, information exchange logic and the route from construction BIM toward handover BIM.

05 · ACC / CDE setup

Organized the folder structure and information states on ACC so the team worked in one controlled environment.

06 · Federation logic

Separated internal typical villas from external villa-specific packages to make the development manageable and coordinated.

07 · Team follow-up

Made sure the disciplines and subcontractors were working through the same sequence, checks and weekly review cycle.

08 · Dashboards and follow-up

Built KPI, clash and submission dashboards to make weekly status visible and easier to manage.

09 · Delivery at scale

Managed the information flow across 500+ BIM models and 1,960+ drawing deliverables, keeping coordination and drawing production aligned across the project.

03 / YAS RIVA

Process

The workflow moved in a clear sequence. Each stage created the input for the next one, and the whole process fed the weekly project delivery cycle.

  1. Receive and review

    Start by understanding the IFC drawings, models and package structure.

  2. Read the requirements

    Use the EIR as the basis for scope, LOD, information exchange and BIM deliverables.

  3. Mobilize the team

    Prepare the BIM Kick-Off and align the project around one common way of working.

  4. Build the system

    Develop the BEP, set up ACC, define the folder structure and build the federation logic.

  5. Run the weekly loop

    Federate the models, review clashes, check quality, follow up submissions and meet the disciplines.

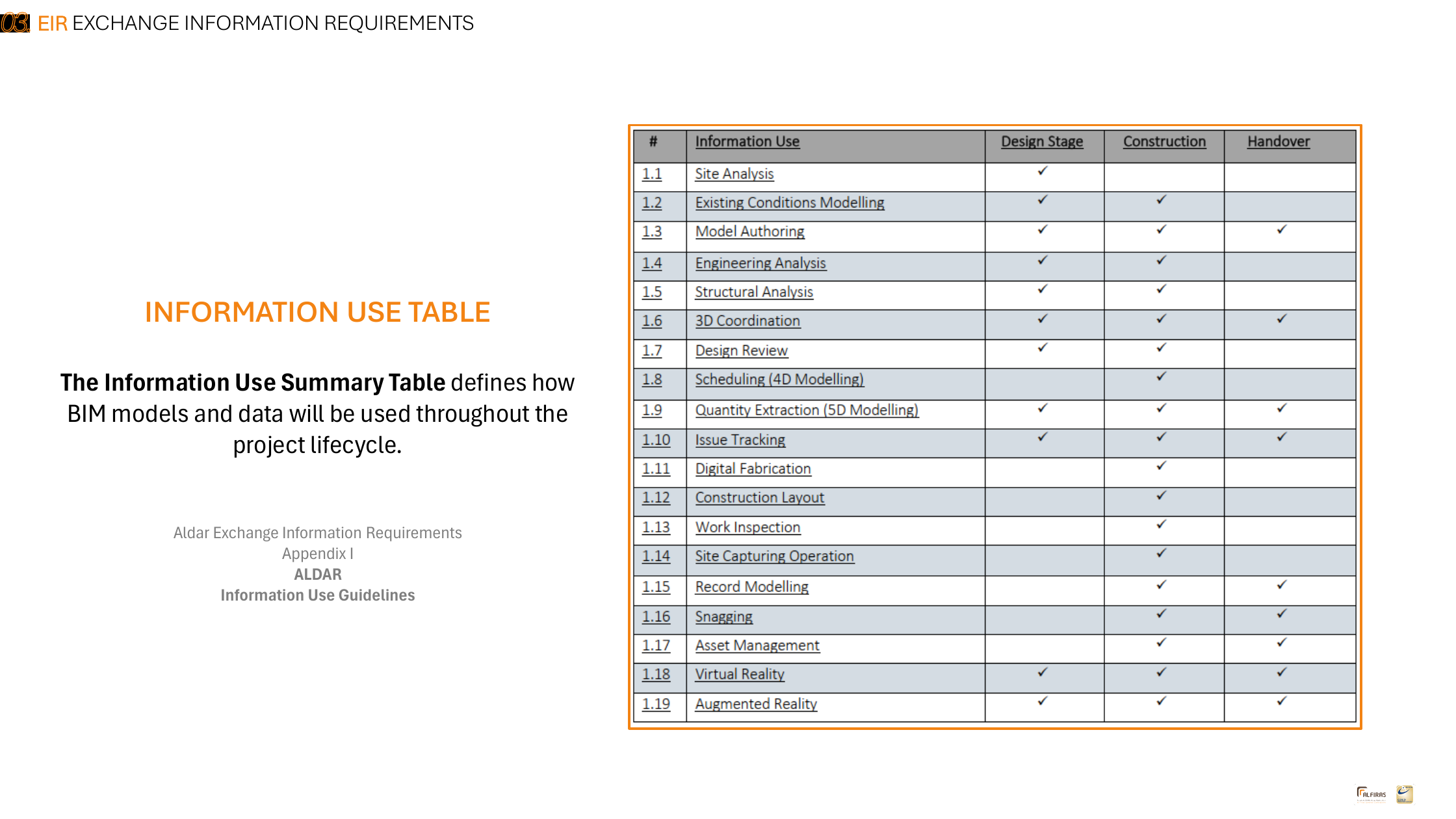

EIR review View detail
EIR / INFORMATION REQUIREMENTS

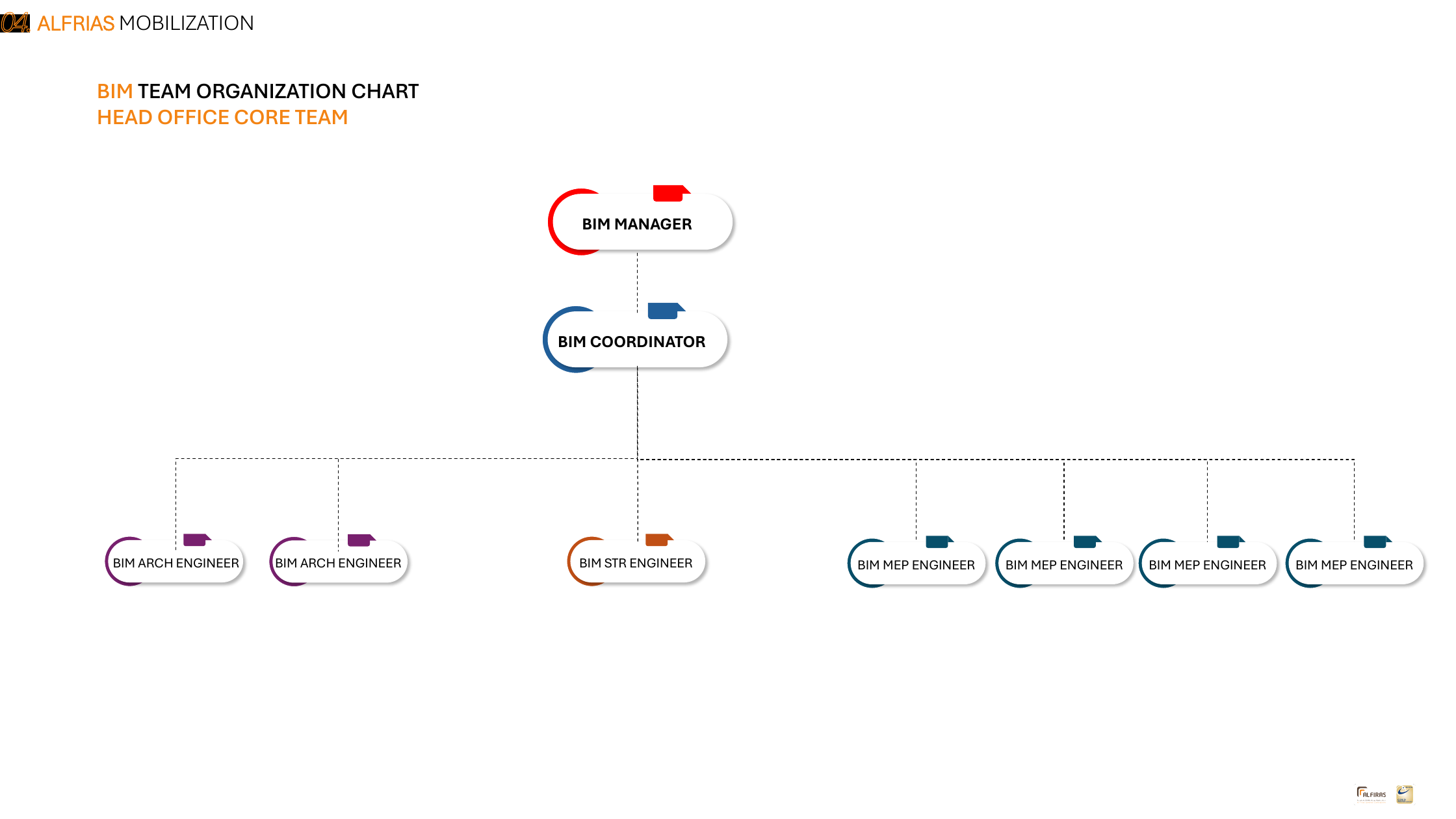

Mobilization View detail
MOBILIZATION / BIM KICK-OFF
BEP View detail
BEP / EXECUTION ROADMAP
ACC folder structure View detail
ACC / CDE SETUP

04 / YAS RIVA

BIM / Technical strategy

The technical side focused on two key systems: the federation strategy and the ACC folder structure. Together, they controlled how information was created, shared and coordinated.

Internal federation View detail

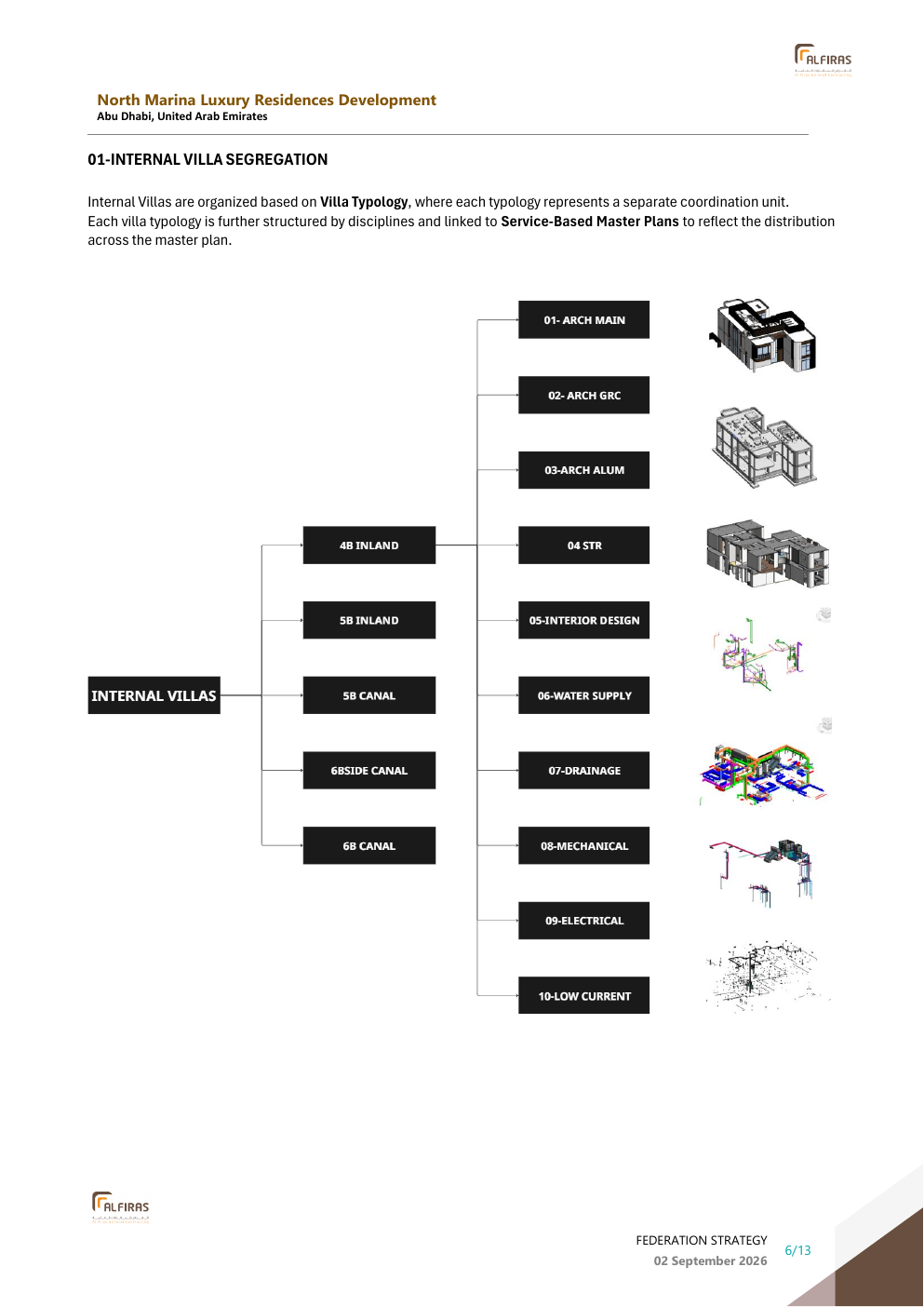

INTERNAL VILLA FEDERATION

Federation strategy

I structured the project around repeatable internal villa typologies and separate external villa-specific packages. This made it easier to coordinate shared logic while still handling each villa’s unique outside conditions, services and interfaces.

ACC folder structure View detail

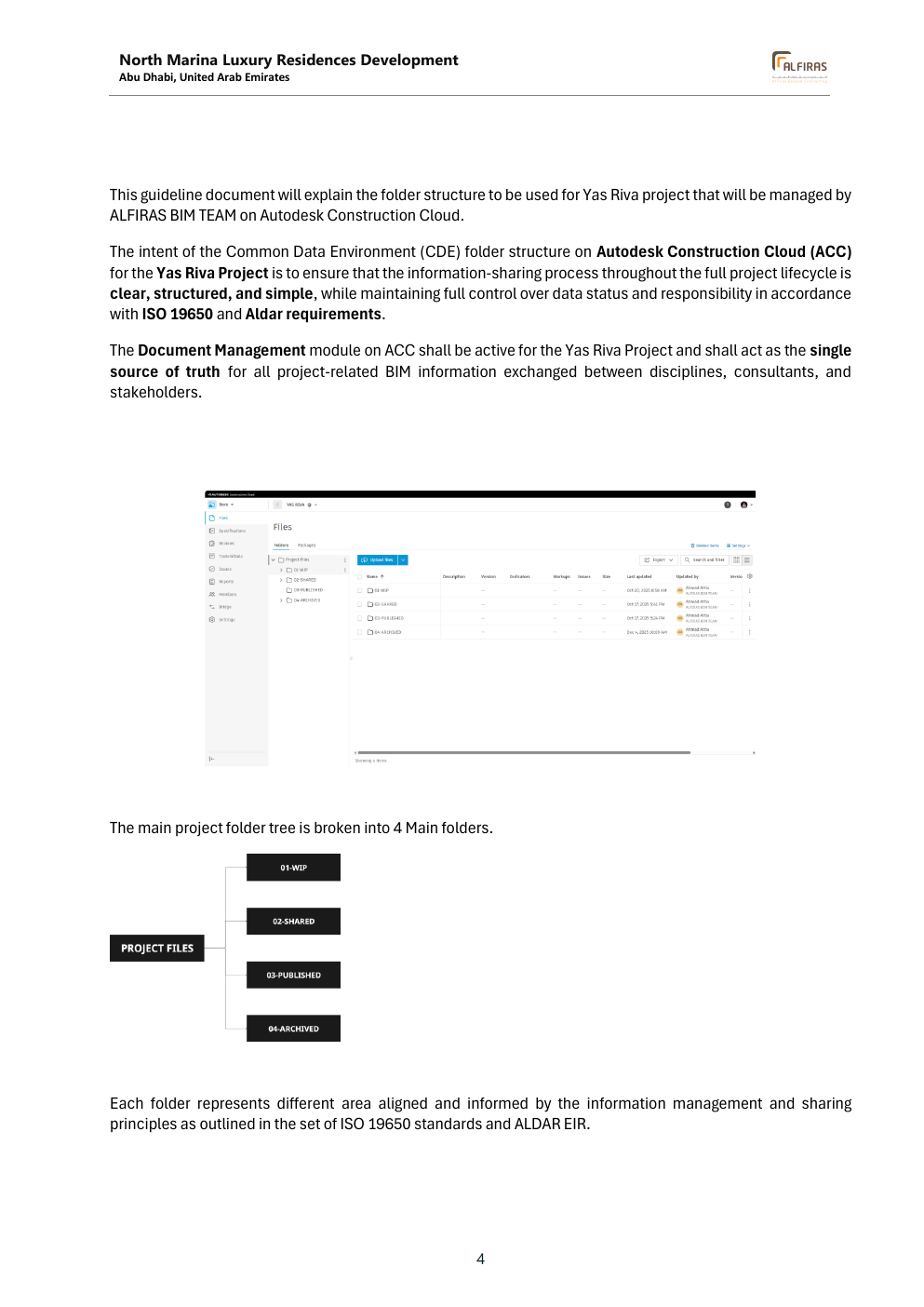

ACC / FOLDER STRUCTURE

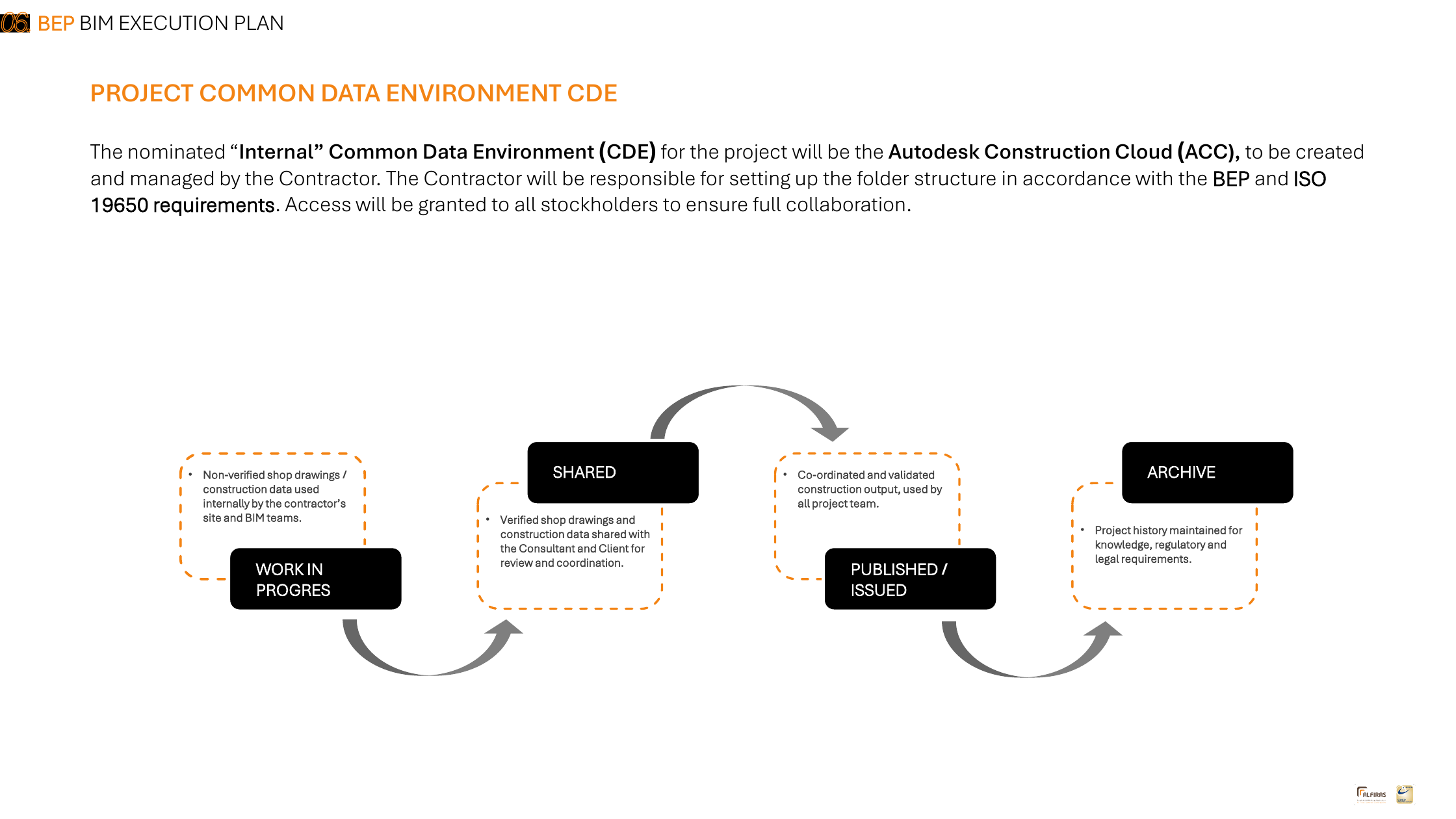

Folder structure

I set up the ACC environment and defined the WIP, Shared, Published and Archived flow. The structure controlled where work lived, when it was ready to share, and how the team moved information through the project.

External federation View detail

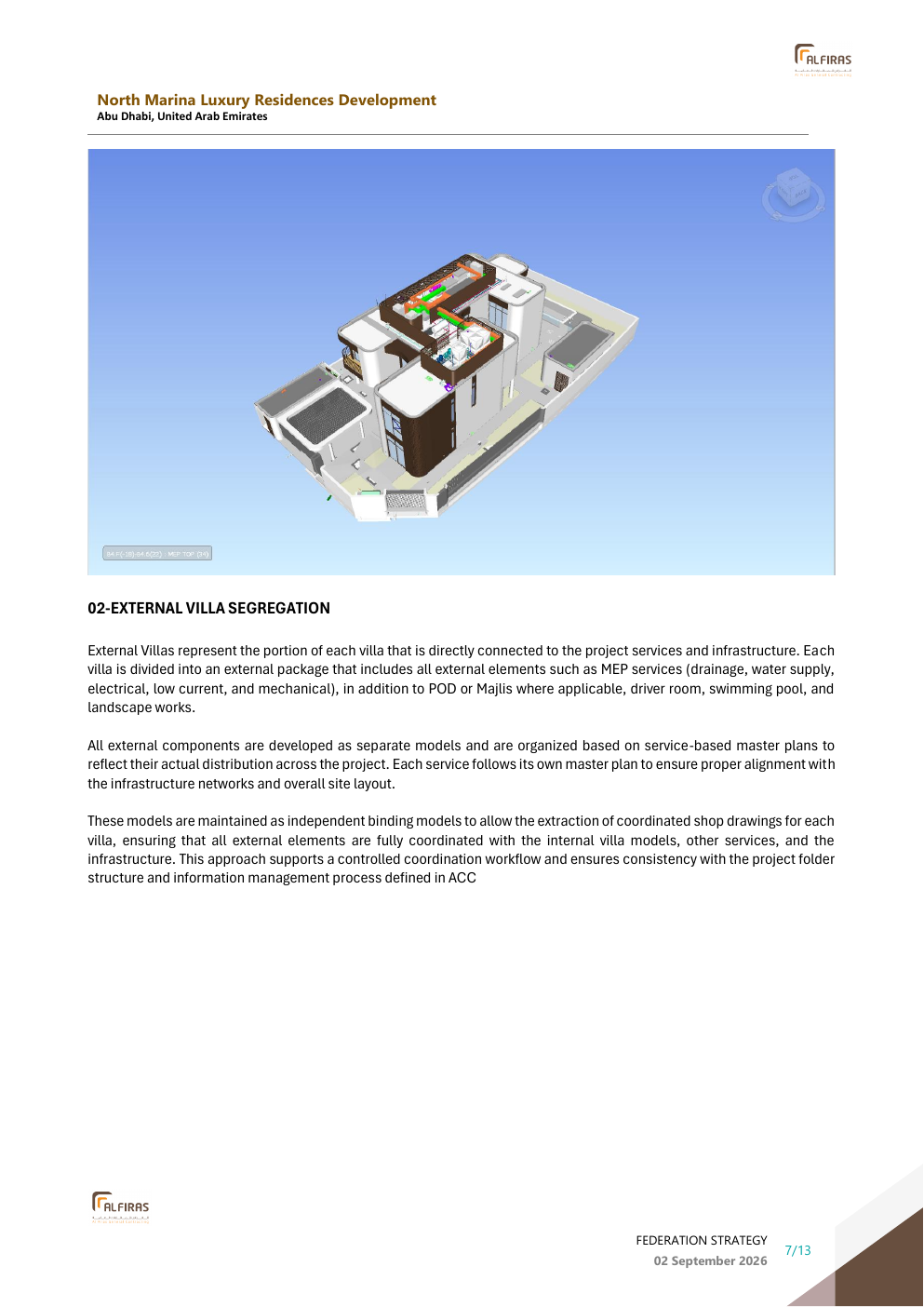

EXTERNAL VILLA FEDERATION

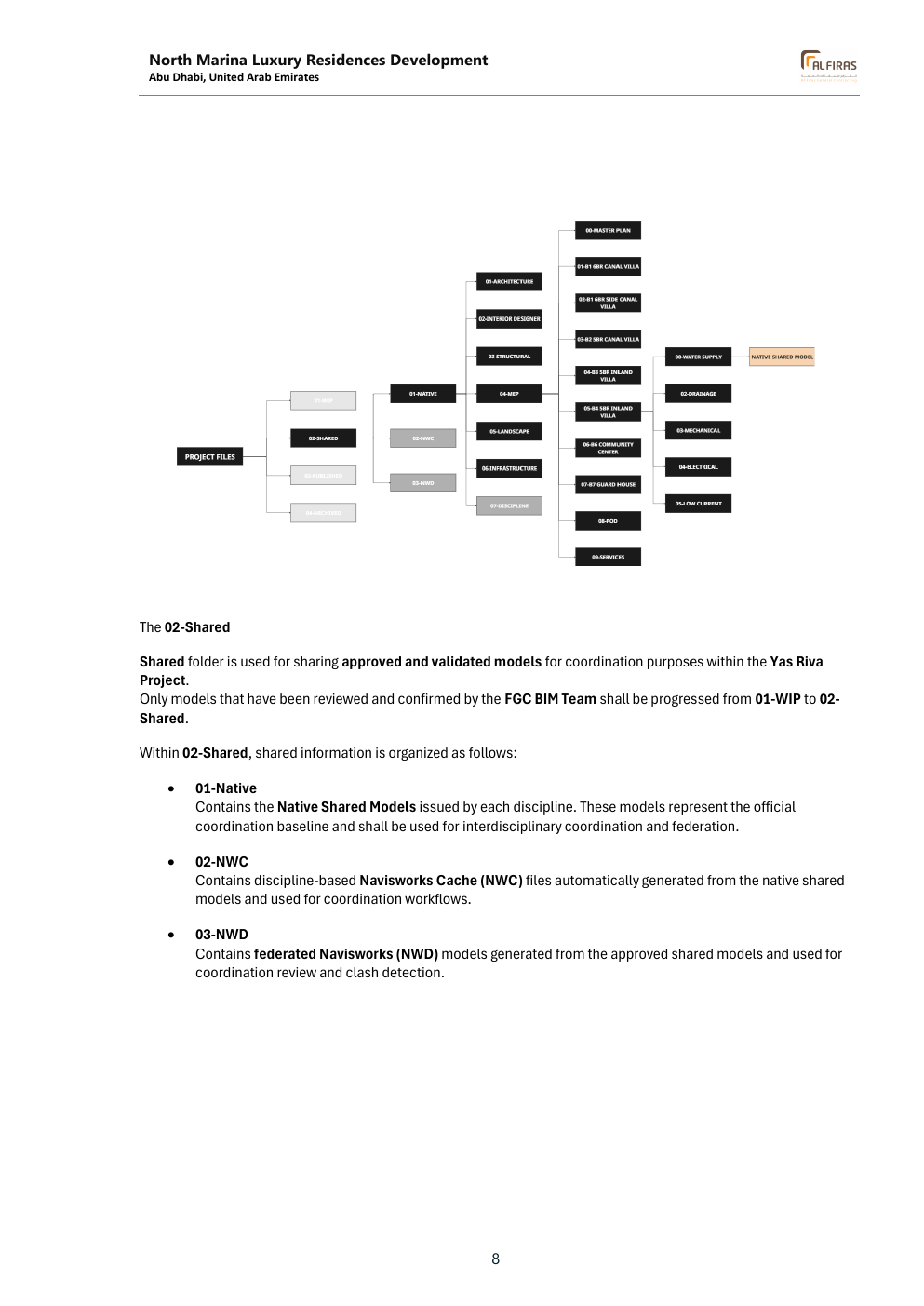

Shared workflow View detail
MODEL EXCHANGE / SHARED WORKFLOW

05 / YAS RIVA

Coordination

I received the clash matrix, checked that it was correctly organized inside the files, and supported the coordination flow around it. On a weekly basis, I uploaded the NWD federated model, reviewed model quality, checked the coordination setup and followed up issues with the project teams and subcontractors.

Clash matrix setup

Reviewed the clash test structure and confirmed that the coordination matrix matched the intended model interfaces.

Weekly NWD upload

Issued the federated Navisworks model as a weekly coordination reference for review and follow-up.

Quality checks

Checked model readiness, links, naming, coordination status and the quality of the shared content before issue.

Follow-up meetings

Used meetings with disciplines and subcontractors to close gaps quickly and keep the next weekly cycle moving.

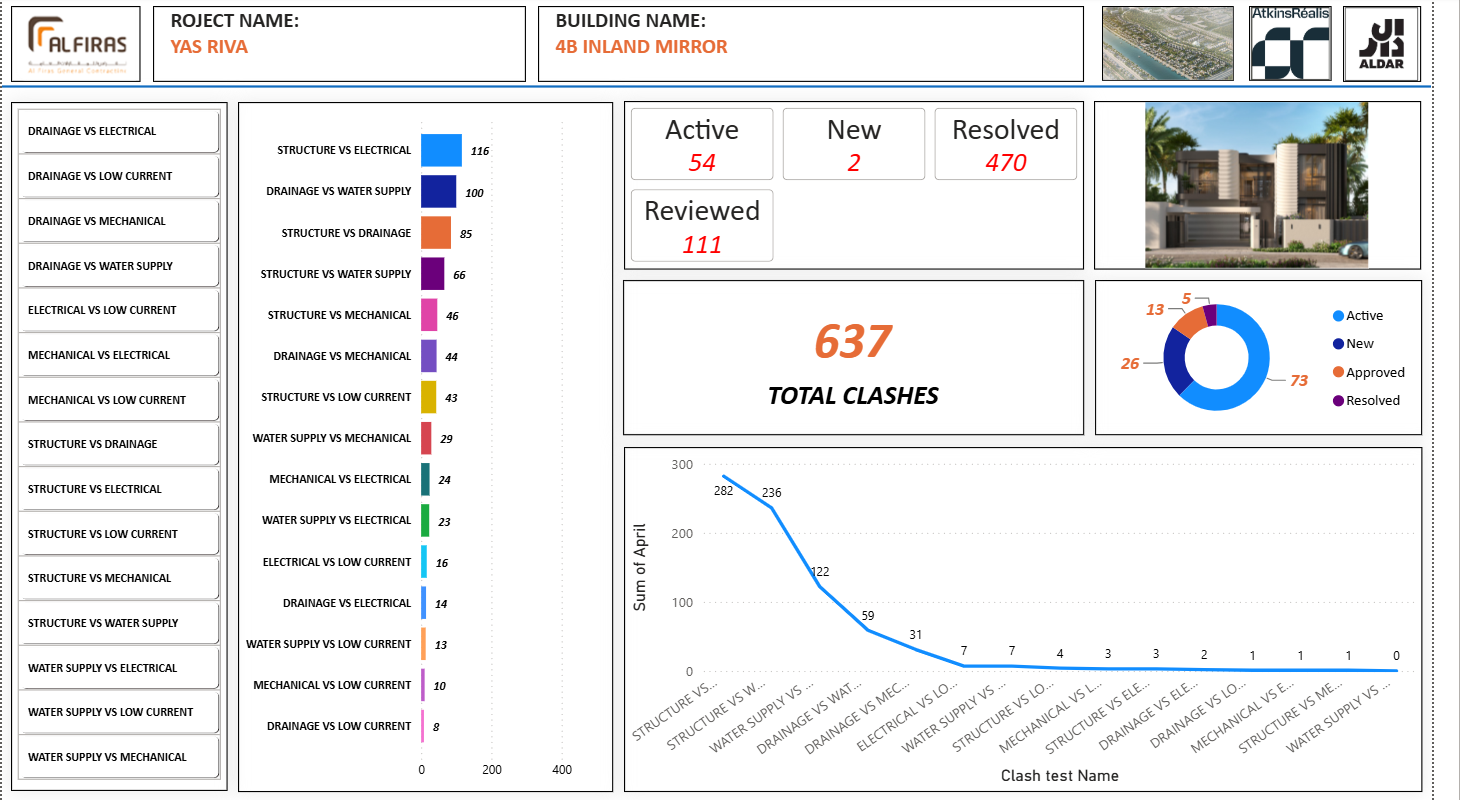

Clash dashboard View detail
CLASH MANAGEMENT DASHBOARD

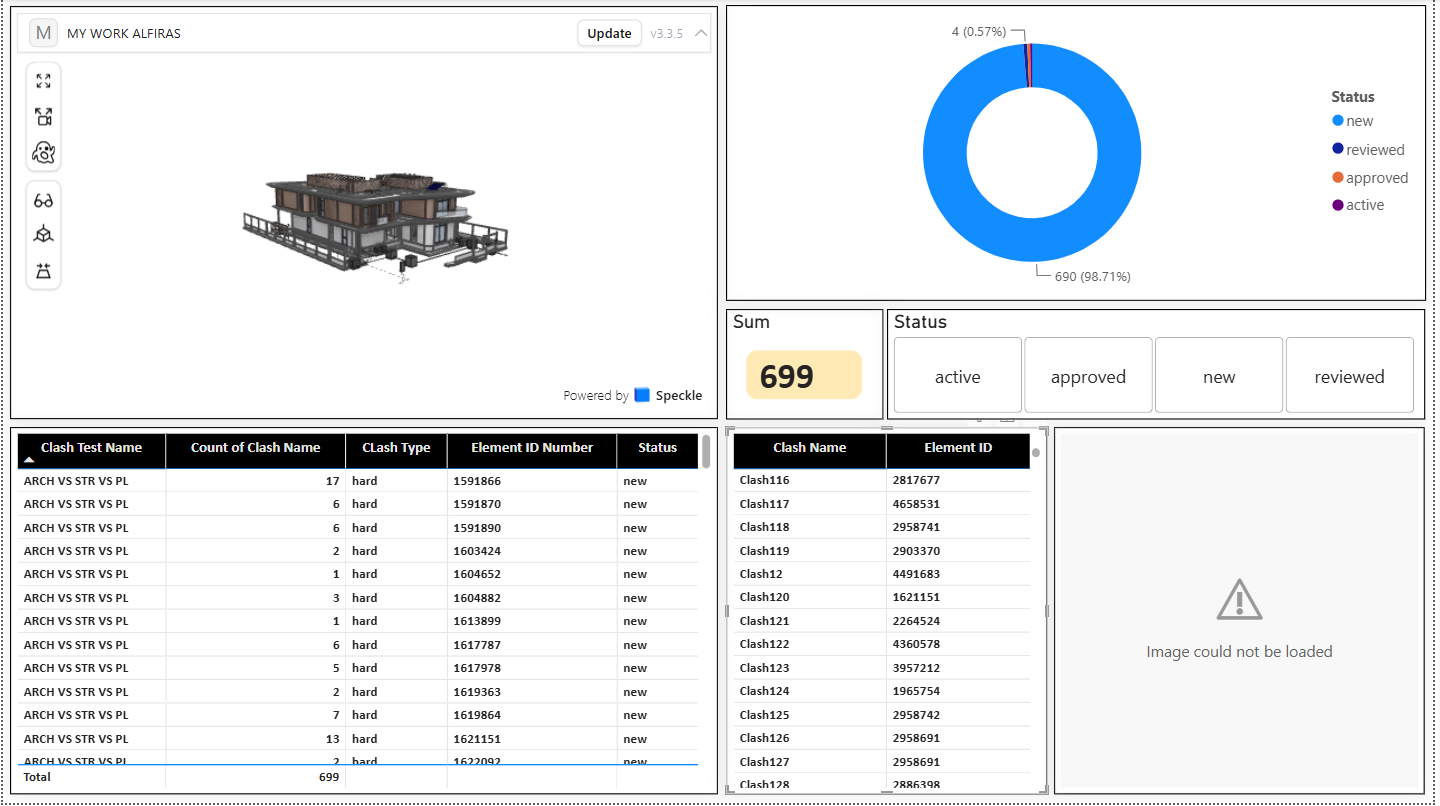

Model-linked issue review View detail
MODEL-LINKED ISSUE REVIEW

06 / YAS RIVA

Output

The result of the work was a set of structured project outputs supporting delivery, coordination and follow-up.

01

BIM Kick-Off presentation

Prepared the project kick-off presentation to align scope, responsibilities, workflow, QA/QC and coordination expectations.

Kick-off View detail
BIM KICK-OFF
Project overview View detail
PROJECT INTRODUCTION
02

BEP and BIM management documents

Defined the delivery roadmap, information exchange logic and the project BIM management sequence.

BEP View detail
BEP / EXECUTION ROADMAP
EIR View detail
EIR / REQUIREMENTS BASELINE
03

ACC folder structure and shared workflow

Set up the project information environment and the folder workflow used by the team to move information through the project states.

Folder structure View detail
FOLDER STRUCTURE
Shared workflow View detail
SHARED WORKFLOW
04

Federation strategy and villa federated models

Created the federation logic and supported the federated model setup used for villa-level coordination.

Internal federation View detail
INTERNAL FEDERATION
External federation View detail
EXTERNAL FEDERATION
05

Dashboards and tracking tools

Built dashboards for KPI progress, clash follow-up and submission tracking to support the weekly management cycle.

KPI dashboard View detail
KPI DASHBOARD
Clash dashboard View detail
CLASH DASHBOARD
06

Coordinated shop-drawing delivery

The reviewed and federated model workflow provided the coordination base for 1,960+ drawing deliverables, helping shop drawings remain aligned with architectural, structural, MEP and site interfaces before submission.

07 / YAS RIVA

Result

The project was managed as one connected BIM delivery system — coordinating 500+ BIM models and supporting 1,960+ drawing deliverables instead of treating 151 villas as isolated packages.

Coordinated shop drawings

The coordinated BIM workflow supported the extraction and review of shop drawings from federated models, helping maintain alignment between disciplines and site interfaces before submission.

Fewer coordination gaps

Model federation, clash review and weekly quality checks helped identify conflicts earlier, before they reached the drawing and construction stages.

Villas
151
BIM models managed
500+
Drawing deliverables
1,960+
Federated delivery loop
Weekly
